Report check, approve or reject
Project managers and supervisors work in slightly different views. This chapter shows how reports are reviewed and approved or rejected in both roles.
Project managers
Project managers have two ways to perform the check. Which variant fits depends on whether the check is done per project or per person.
Project managers see the entire week of a person in context (including absences and entries outside their own projects). However, you can only approve or reject entries on your own projects.
Variant A: Project-based
Check all reports of a project. Suitable when the check is done per project.

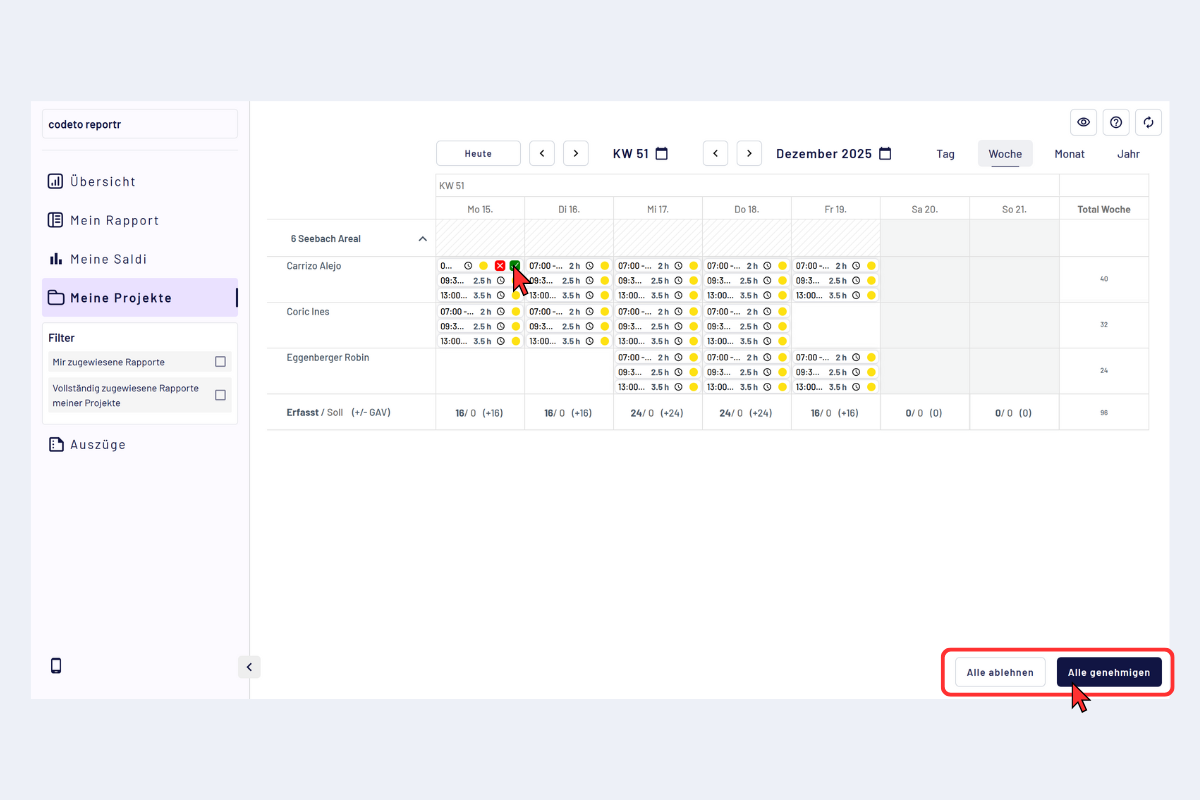

In "My projects", accept or reject reports directly. The action applies to all employees who booked on this project on that day.

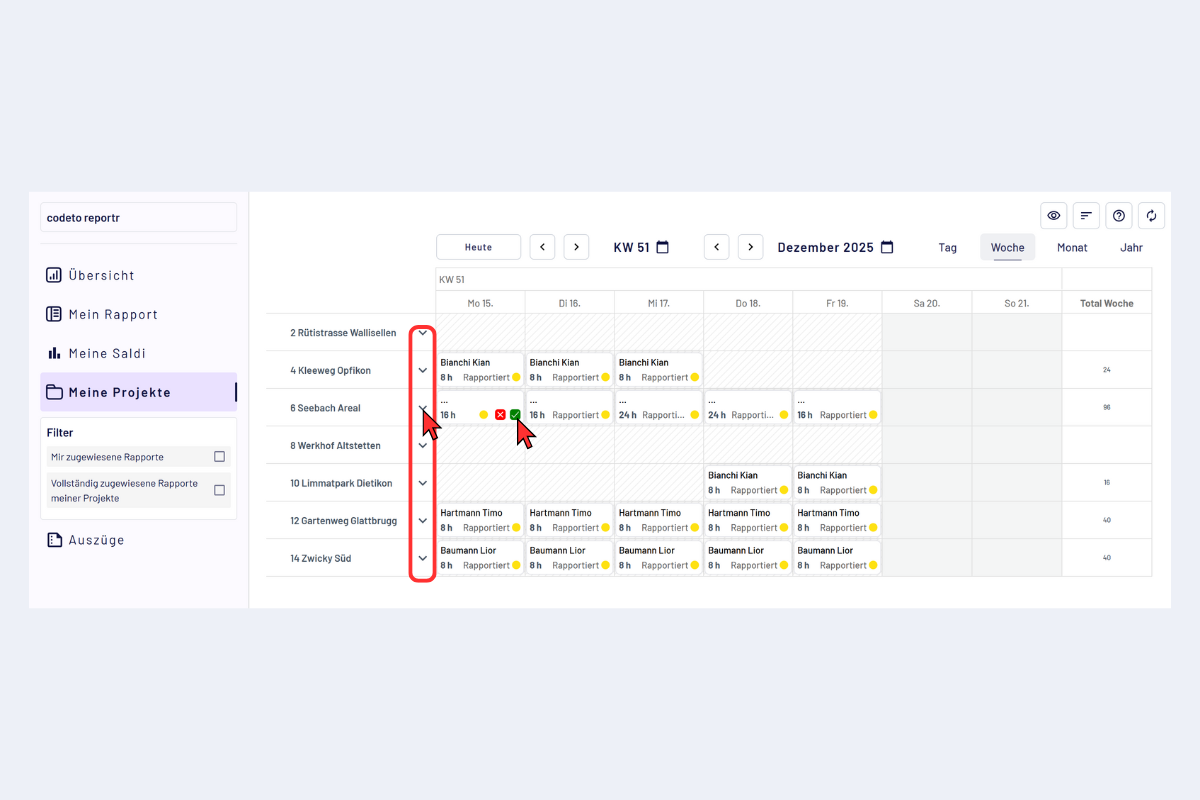

Project manager, project view

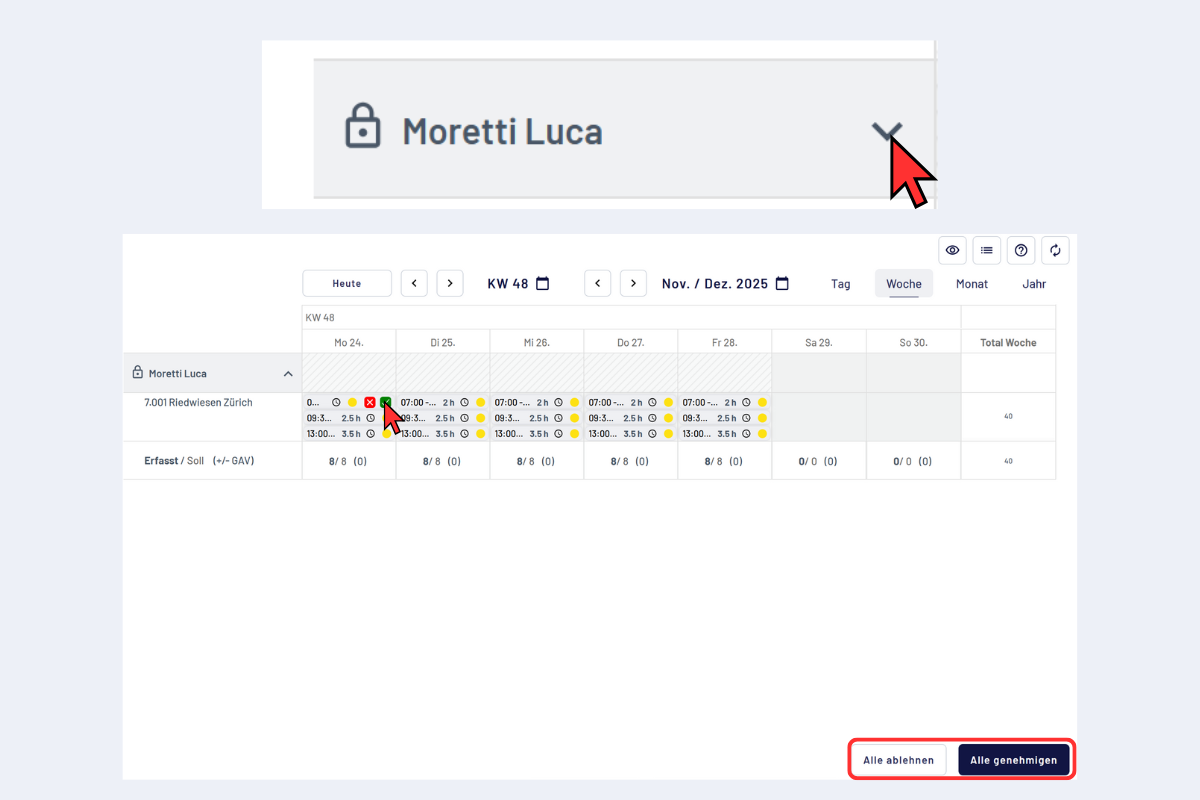

Recommendation: open the detail view via "Details" next to the project name. The details appear on a separate page. Then it is visible who booked on which day. Approve or reject individual blocks, or use "Approve all" or "Reject all" at the bottom right.
Project manager, detail page of a project
Variant B: Employee-based
Review the entire week of a person in context. Suitable when the week as a whole is to be assessed.

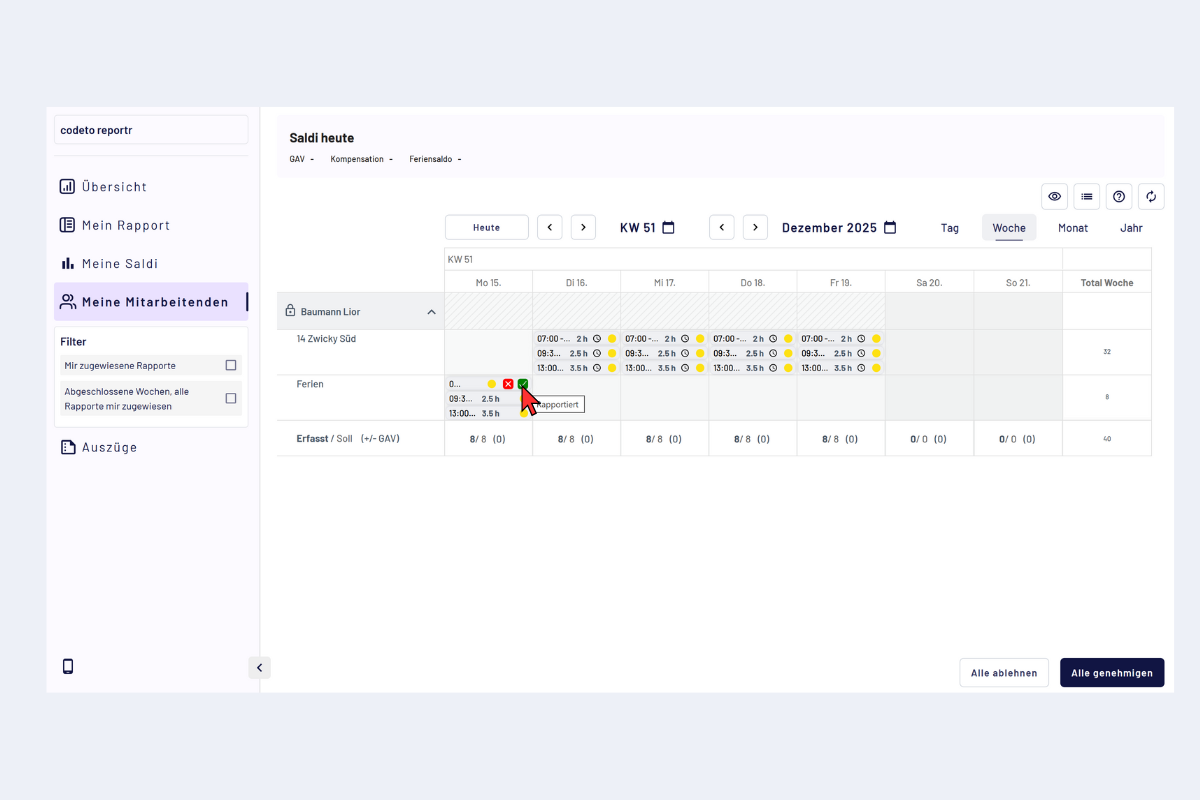

- On the overview page, under "My employees", expand the "Reports to be approved" area.
- The employees with reports to be approved appear. If "Group" is active, the weeks per person can be expanded via the plus icon.
- Use "View week" to jump directly into the week.

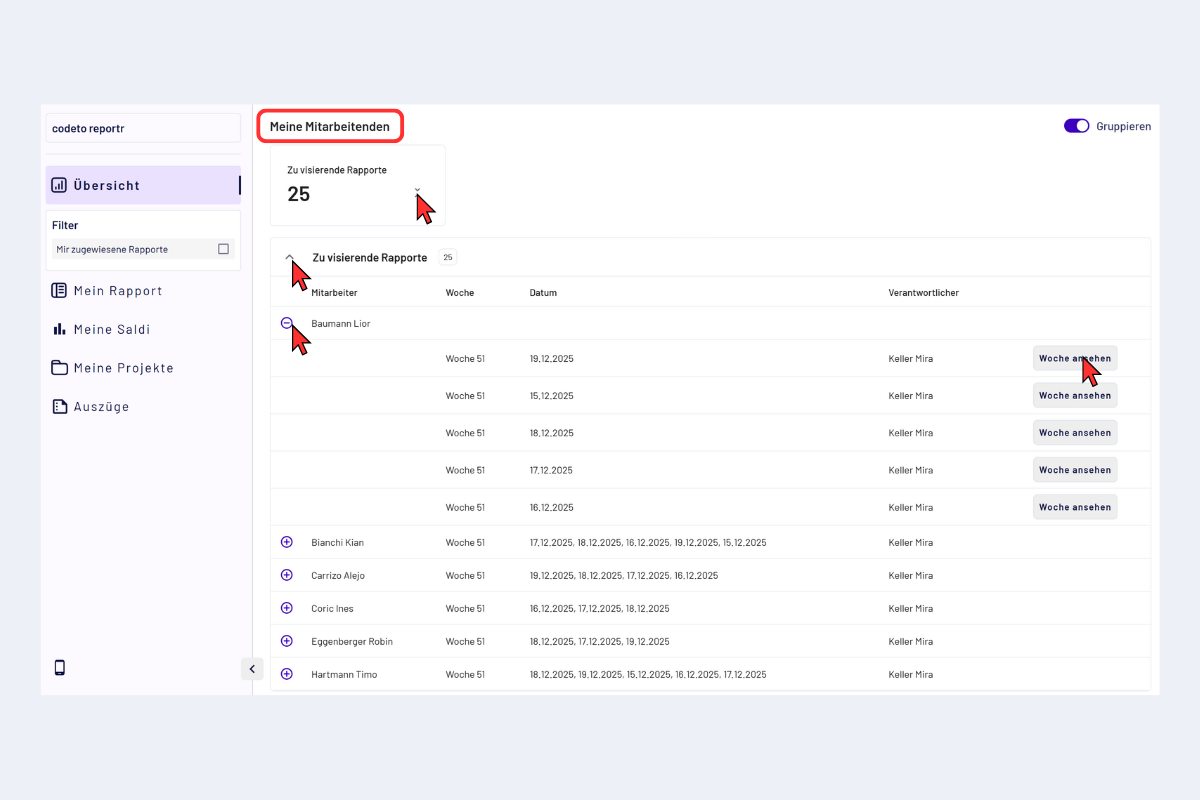

Project manager, employee overview "Reports to be approved"
Project manager, week of an employee
Combine entries
In the report check, identical entries can be combined via the clock icon ("Aggregate") in the header, so that not every block is shown individually but directly the total hours for the project on the respective day.
Only entries that match in all characteristics are combined: same day, same project, no additional notes, no different surcharges or additions. As soon as even a single detail differs, the entries remain visible as separate blocks.

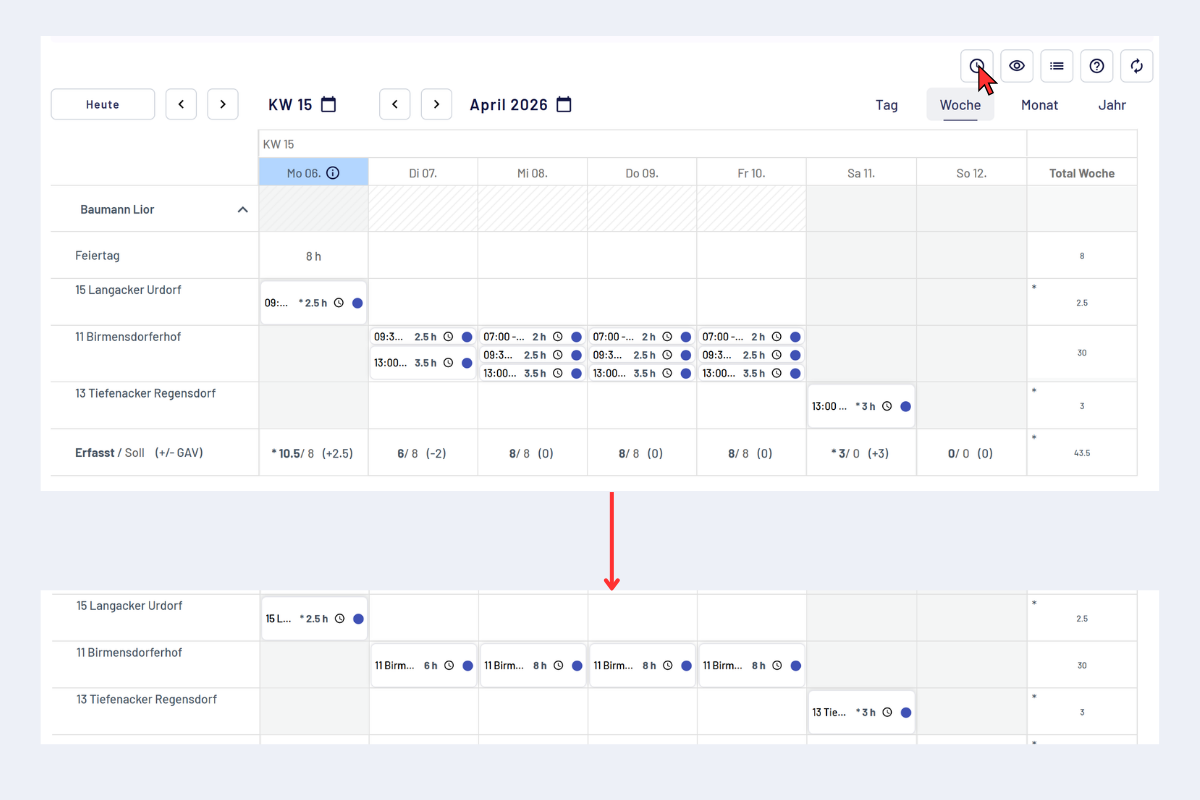

Example: Three bookings on the same day on the same project, without note and without surcharge, are combined into one entry with the sum of the hours. If, on the other hand, two blocks are present, one from 07:00 to 09:00 with note A and one from 09:30 to 12:00 with note B, both remain shown separately.
Report check, individual from-to entries at the top, combined at the bottom
Detect reporting restrictions
In "My projects", a lock next to the project name shows that a reporting restriction is active or upcoming for the project. The period from today to the end of the current calendar year is decisive, regardless of the period displayed.
- The subline names the active restriction, otherwise the next one.
- When you hover over the subline, the relevant periods with their status appear under "Reporting restrictions". Restrictions without an end are marked as indefinite.
- Expired restrictions and restrictions that only start next year are not marked.
- The period before the company's reporting start can also appear as a restriction.
Reporting restriction next to the project name with periods
A click on the project name opens the project details, "Details" opens the report view.
Supervisor check (often back office) and supervisors
Supervisors work in the "My employees" tab. Anyone who is both project manager and supervisor has both views available.

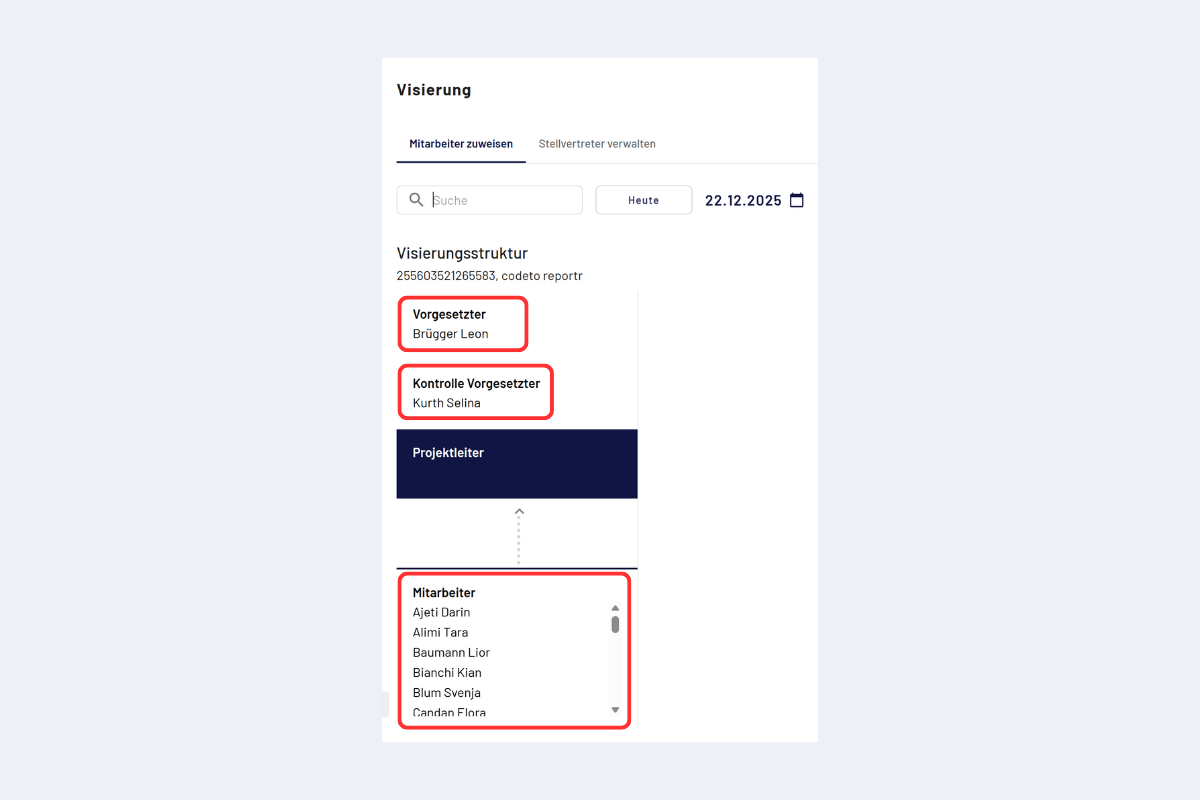

Which employees appear? All persons who are placed below you in the approval structure. Changes to this list are only possible with admin permission.
Supervisors, list of employees

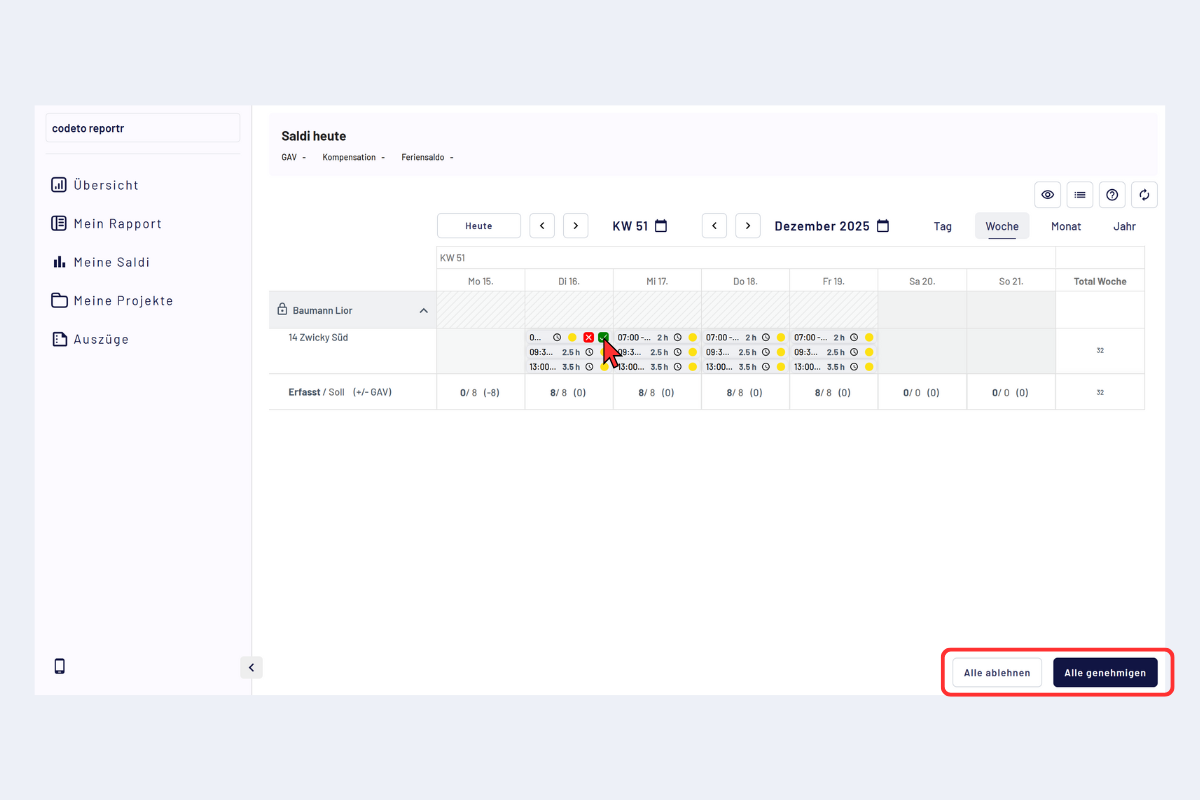

Accept or reject reports directly, or open the detail view per employee via "Details" to review the period (day, week, month or year) more precisely. The employee's detail view opens on a separate page. When you return, the scroll position of the overview is kept so that the check can continue at the same place. In the detail view, all reports can be released or rejected at once, or alternatively individual blocks.
Supervisors, detail view per employee
Review weeks one after another
On the overview page, "Start approval" in the "Reports to approve" area opens the pending employee weeks one after another. The order follows the filtered list.
Overview: "Start approval" in "Reports to approve"
Week review with progress and actions
- "Approve & next" approves the week and opens the next one. For the last week, the button is called "Approve & return to overview".
- "Reject & next" rejects the week and opens the next one. For the last week, the button is called "Reject & return to overview".
- "Skip for now" moves on without approving. The week stays open.
- The back button and the progress indicator show the position in the sequence and let you change it.
At the end, the application returns to the overview. Period, search and filters are kept, and the list is refreshed. If reports in a week are still pending or the refresh fails, a message points this out.
The review is meant for checking. Depending on permissions, existing reports can be edited or deleted; new reports are not created here. General additions, balances, audit log and rule confirmations remain accessible according to the existing permissions. The width of the first column is saved separately for the week review, see Width of the first column.
"View week", on the other hand, opens a single week without a sequence. After a bulk approval, the application returns to the overview once the refresh succeeds; after individual report actions, the review stays open.
Filters
The filters apply identically in "My employees" and "My projects".
- Reports assigned to me: all reports currently assigned to me, including individual forwarded days.
- Closed weeks, all reports assigned to me (in "My projects": Fully assigned reports of my projects): only fully closed weeks. Here the approval of the entire week is pending.
- Approval step: filter reports by approval stage.
Date quick filters for open reports
For open reports there are date quick filters: current month, last month, last three months, start of year. Useful for daily checks or for reviewing older periods.
Approve and reject
Two ways:
1) Per day via mouse action

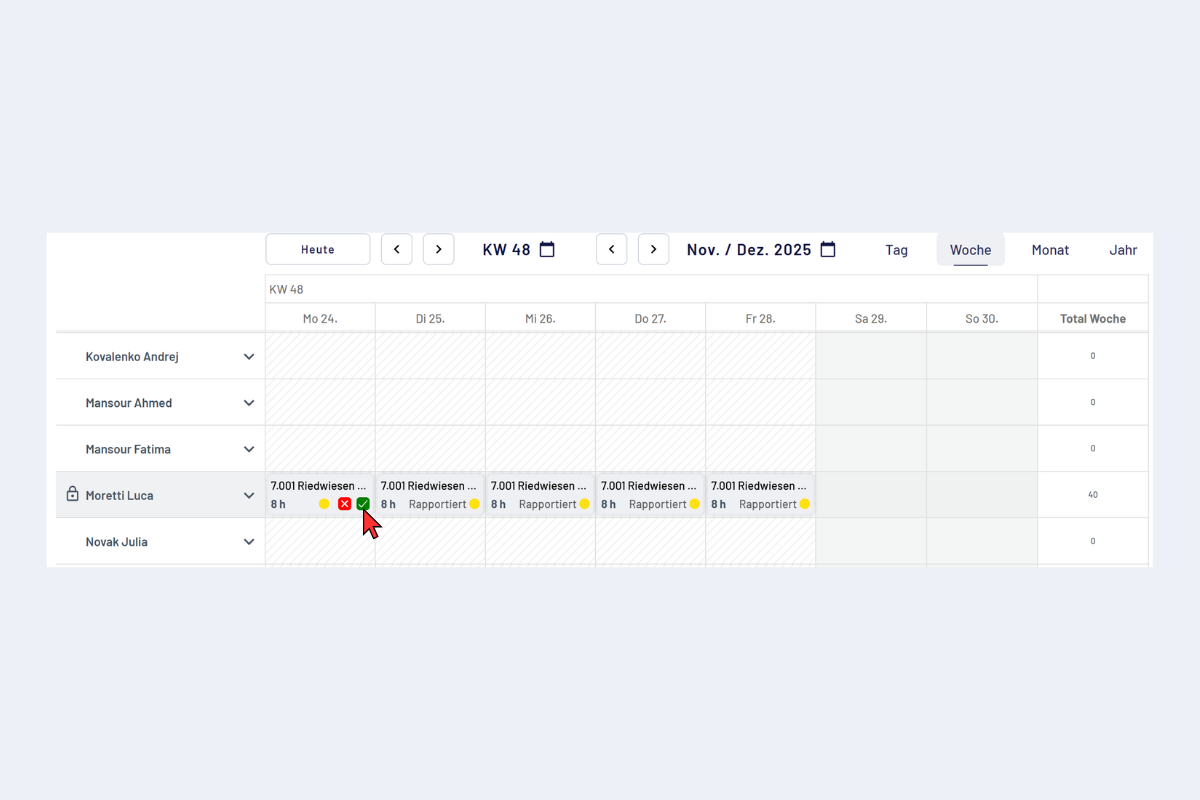

Hover over a report; a green check mark (approve) and red cross (reject) appear. The action applies to the entire day, even if the day consists of several blocks.
Approve and reject, per day
2) Detail page for block precision (recommended)
Open the detail view via "Details" next to the name. In the overview, one combined entry appears per day; on the separate detail page, the individual blocks per project become visible (in the example 07:00–12:00 and 13:00–16:00 on Projekt A).
At the top the overview with "Details" for Coric Ines, at the bottom her detail page with the individual blocks
Detail page, approve or reject a single block, "Reject all" and "Approve all" at the bottom right
- Approve or reject individual blocks with check mark or cross.
- Click on a block opens a pop-up with details.
- At the bottom "Open week" to make your own adjustments.
- "Approve all" or "Reject all" are possible.
- Rejecting always requires a reason.
- If rejecting would reopen a closed week of a previous payroll year, a Super User (SU) is required, see Payroll year limit.
At the end of the approval, check the general additions of this week and add them if needed, see Check and add general additions.
